Thursday 16 May 2013

Practical Completion Inspection


Today we had our Practical Completion Inspection (PCI).  It went reasonably well with nothing major to be fixed. The things that need attention are:

Entry
  • Weather seals on entry door
  • Repaint entry door as it has a few scratches on the exterior side
  • Paint touch ups
Master/Ensuite/WIR
  • Centre tiles above niche in ensuite shower to be replaced
  • one of the vanity doors in the ensuite has a couple of red marks on it
  • Paint touch ups
Lounge/Dining/Kitchen
  • Replace some quad to the flooring in the dining/lounge area
  • Clean off glue to some window frames
  • clean marks on the island bench
  • Add globe to living room batten
  • Paint touch ups
Rumpus Room
  • silicone bench top to wall in rumpus room
  • relace damaged quad to flooring
  • repair gaps between skirting boards & quad (nail in)
  • Paint touch ups
Laundry
  • replace fly screen in laundry as it isn't square & doesn't fit window
  • Magpie vent to be inserted
  • Clean the runs in the sliding external door
  • Paint touch ups
Hallway
  • Replace globe to Batten
  • Clean mud marks off man hole
  • Paint touch ups
Bedroom 2
  • Adjust levels of the robe doors so they close flush
  • repair hole in the floor & the back of the robe
  • Paint touch ups
Bedroom 3
  • Adjust robe doors to close flush
  • Clean window frame
  • Paint touch ups
Bedroom 4
  • Remove glue from window frame
  • Paint touch ups
Bathroom
  • clean grout on floor
  • Repair tile on bath hob as it sits above the trim
  • Mark on bench top
  • Silicon Bath hob to wall
  • repair tile on side of shower that is not straight
  • Paint touch ups
Garage
  • Finish skirting around the rear door
  • Replace rear door handle
  • Clean the brickwork around external door
  • Paint touch ups
External
  • Add infill above the master bedroom window
  • Cracked brick at the bottom of alfresco wall
  • Chip to alfresco slab
  • Repaint outside of alfresco beam
  • Touch up infill above the garage door
  • Brick cleaning touch ups
Our Site supervisor estimates everything will be finished and ready for handover on Tuesday 28th May.

Sunday 12 May 2013

Construction - Week 21

Only 5 days to go til our inspection and the list is getting shorter



Laundry
  • The magpie vent needs to be completed
Kitchen
  • Glass splash back needs to be installed
  • All appliances need to be installed

External
  • Portico needs to be painted


Monday 13th May 2013

Today the portico was painted meaning that all the external painting has now been completed. The painter has also done some touch ups inside.

Wednesday 15th May 2013

Nothing else has been done so far this week, hopefully the splashback will go in tomorrow in time for our PCI on Friday morning. We have already been told the magpie vent wont be done til after our inspection & the appliances wont be installed until hand over so that only leaves the splashback & everything will be done.

Friday 17th May 2013

Today while we were doing our PCI the glass splashback was installed in the kitchen, I'm very happy with the way the colour has turned out & am even happier to find out it goes up the wall behind the range hood as well as along the bench.



The blinds were also installed today




Sunday 5 May 2013

Construction - Week 20


With less than 2 weeks til our PCI the list of outstanding things is slowly getting shorter

Bathroom & Ensuite

  • The Basins & Bath are in but they are yet to be fixed
  • There is a missing tile on the edge of the bath (so the plumbing for the bath can be connected) this needs to be complete
  • The Grout on the splashbacks need to be finished
  • The shower drain need to be put in
Laundry
  • The laundry Taps need to be installed
  • The magpie vent needs to be completed
Kitchen
  • Glass splash back needs to be installed
  • All appliances need to be installed
Internal
  • All carpet needs top be laid
External
  • All external painting needs to be done
  • Portico needs to be painted
  • Fly screens to all windows
  • Gap in brick work above the ensuite window needs to be filled
  • The rear garage door needs to be painted and hung


Monday 6th May 2013

Today the external painting began with the render being painted. I'm very happy with the way it has come up.



Tuesday 7th May 2013

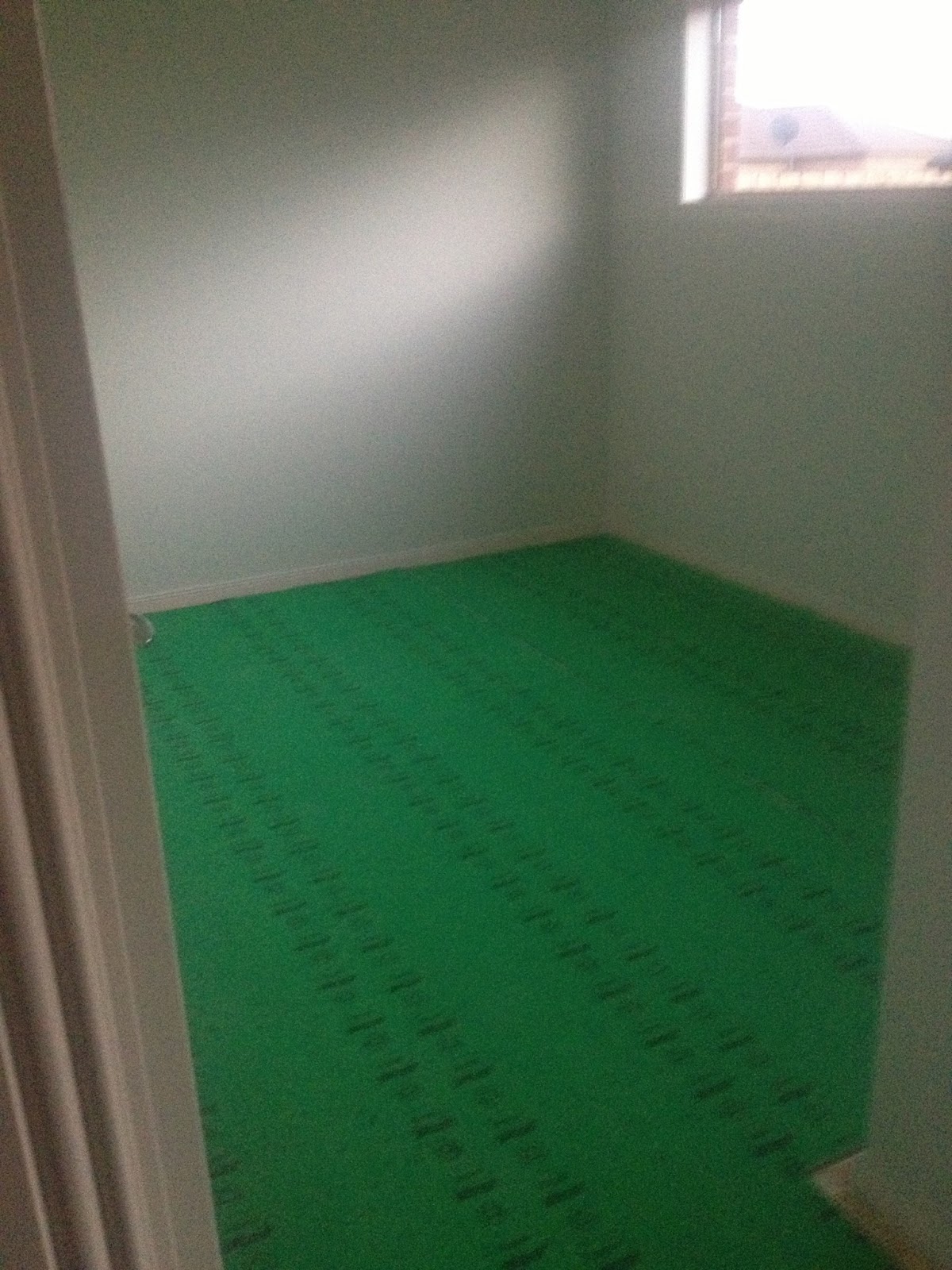

Today the underlay was laid for the carpet


Wednesday 8th May 2013

Today the plumber returned & connected the bath & fixed the missing tile.
He also connected the laundry taps which now makes the laundry complete (except for the magpie vent which we have been told will be done between PCI & handover)




The painters were also back & finished all the external painting except the portico. They also painted the rear garage door.




Thursday 9th May 2013

Today the carpet was laid, it is a little browner than what I pictured it to be & the photos make it look even browner than it is & really don't do it justice at all. Although it is browner it still ties in well with our colours


The tiler was back and finished the grout in the bathroom & ensuite, leaving only the sealing to be done which we have been told will be tomorrow.


The cleaners were also back today, it has made such a difference to everything to see it clean rather than covered with dust & dirt



 Friday 10th May 2013

 Today the basins & bath we fixed and the bathrooms sealed, the shower drains were also put in meaning that the bathroom & ensuite are now complete.


The rear garage door has been hung, the gap in the brickwork above the ensuite window has been fixed & all the fly screens are on.
